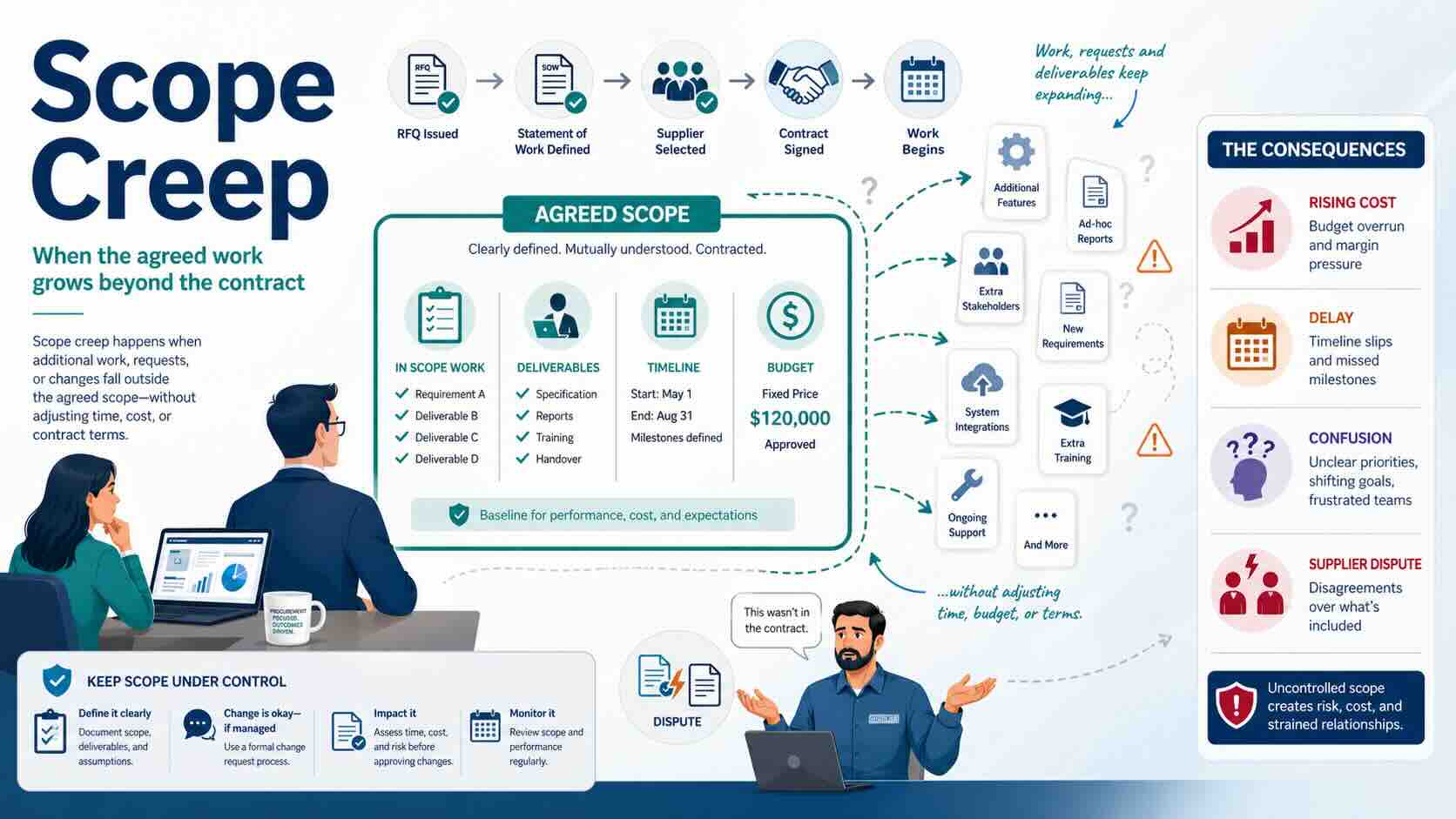

Scope Creep in Procurement: How Buyers Prevent Uncontrolled Cost, Delay, and Supplier Disputes

Scope creep is one of the most common problems in service procurement, project sourcing, consulting assignments, outsourcing, IT services, maintenance agreements, and supplier-led implementation projects.

It often starts small.

An internal stakeholder asks the supplier to “just add one more thing.”
The supplier accepts without a formal change.
The buyer assumes the activity is included.
The supplier later sends an extra invoice.
The project timeline moves.
The contract owner becomes frustrated.
Procurement is asked to solve a dispute that should have been prevented earlier.

This is scope creep.

In procurement, scope creep usually happens when the Service DescriptionStatement of WorkService Level AgreementRFQ, contract, or change-control process is unclear. The supplier may not know exactly what is included. The internal stakeholder may expect more than what was agreed. The buyer may not have defined how changes should be requested, approved, priced, and documented.

The result is uncontrolled cost, unclear responsibility, delivery delays, and commercial disagreement.

In this article, you will learn what scope creep means in procurement, why it happens, how it connects to the RFQ and contract, and how buyers can prevent it before it becomes a supplier dispute.


LHTS framework connection

Role: Tactical procurement
Supporting roles: Operative procurement and procurement management
Process: Need definition, RFQ preparation, Service Description, Statement of Work, SLA, supplier quotation, negotiation, contract signing, change control, supplier performance management
Level: Advanced
Related course: RFQ template
Supporting learning: Statement of Work, Service Description, Service Level Agreement,


Quick answer: What is scope creep in procurement?

Scope creep in procurement means that the work, service, deliverables, responsibilities, or expectations expand beyond what was originally agreed with the supplier.

It often happens when the requirement is unclear, the Statement of Work is incomplete, the SLA is vague, the RFQ package is weak, or changes are handled informally.

Scope creep can lead to extra cost, delayed delivery, invoice disputes, poor supplier performance, and internal dissatisfaction.

The buyer’s task is to prevent scope creep by defining the scope clearly before the RFQ, making the final scope part of the contract, and using a formal change-control process after award.


The problem: small informal changes become commercial disputes

Scope creep rarely starts as a large conflict.

It usually starts as a small request.

For example:

  • “Can you also include this report?”
  • “Can you support one more site?”
  • “Can you extend the service hours this week?”
  • “Can you attend these extra meetings?”
  • “Can you include training for our team?”
  • “Can you also handle this system integration?”
  • “Can you make one more design revision?”
  • “Can you add these users to the support service?”

Each request may seem reasonable. But when these requests are not reviewed, approved, priced, and documented, they change the commercial balance of the agreement.

The supplier may later say:

“That was not included in the original scope.”

The stakeholder may respond:

“We assumed it was included.”

Procurement is then pulled into a dispute about expectations rather than a fact-based discussion about the contract.

This is why scope creep must be managed before the contract is signed and throughout the supplier relationship.


Why scope creep matters in procurement

Scope creep matters because it weakens the buyer’s control over cost, time, quality, supplier accountability, and internal expectations.

When scope creep is not managed, the organization may face:

  • higher supplier cost
  • additional invoices
  • delayed delivery
  • lower service quality
  • unclear responsibility
  • supplier frustration
  • stakeholder dissatisfaction
  • contract disputes
  • weak supplier performance follow-up
  • poor budget control
  • difficult project closure

Scope creep also makes supplier comparison more difficult. If the original RFQ did not define the scope clearly, one supplier may price a narrow version of the work while another supplier prices a broader version. The buyer may then select the lowest offer without realizing that the price is based on missing scope.

A low price is not a good price if the scope is incomplete.


Typical causes of scope creep

Scope creep is usually not caused by one single mistake. It often comes from several weak points in the procurement process.

1. Weak need definition

If the business need is not clearly defined before the RFQ, the supplier must make assumptions. These assumptions later become a source of disagreement.

A stakeholder may know what they want in practice but fail to explain it clearly in the sourcing documents.

2. Unclear Service Description

The Service Description should explain what service the buyer wants to purchase. If it is too broad or vague, suppliers may interpret the service differently.

For example, “IT support” is not a sufficient Service Description. The supplier needs to know users, systems, locations, service hours, support channels, responsibilities, exclusions, reporting, and service levels.

3. Incomplete Statement of Work

The Statement of Work, or SOW, should define the work, deliverables, responsibilities, assumptions, timeline, exclusions, and acceptance criteria.

If the SOW does not clearly state what is included and excluded, scope creep becomes likely.

4. Vague SLA

The Service Level Agreement, or SLA, should define how well the service must perform. If the SLA is unclear, stakeholders and suppliers may disagree about response time, availability, quality, reporting, escalation, or service performance.

5. Missing exclusions

Many buyers describe what is included but forget to describe what is not included.

Exclusions are important because they prevent false expectations. A clear exclusion can avoid future disputes.

6. Poor change-control process

Even a well-written contract will need changes from time to time. The problem is not change itself. The problem is uncontrolled change.

If there is no formal process for requesting, reviewing, approving, pricing, and documenting changes, scope creep will grow.

7. Direct communication outside procurement

Scope creep often happens when internal stakeholders and suppliers agree changes directly without involving procurement or the contract owner.

The supplier may think the stakeholder has authority. The stakeholder may think the request is minor. Procurement may only discover the change when an invoice arrives.

8. Pressure to move fast

When projects are urgent, teams may skip documentation. They may say, “We will fix the details later.”

This creates risk. Missing details often become expensive after the supplier has started work.


How scope creep connects to the tactical procurement role

Scope creep is mainly connected to the tactical procurement role because tactical buyers prepare RFQs, structure supplier quotations, support negotiations, and help create contract documents.

A tactical buyer should challenge unclear requirements before the RFQ is sent.

Important questions include:

  • Is the service or work clearly described?
  • Are deliverables defined?
  • Are exclusions stated?
  • Are assumptions visible?
  • Are buyer responsibilities clear?
  • Are supplier responsibilities clear?
  • Are acceptance criteria defined?
  • Is an SLA required?
  • Is a formal change-control process included?
  • Will the final SOW become part of the contract?

The tactical buyer does not need to be the technical expert. But the tactical buyer must make sure that the sourcing package is clear enough for suppliers to quote and for the organization to manage after award.


How scope creep connects to operative procurement

Operative procurement often sees scope creep after the agreement is already in place.

An operative buyer may notice:

  • purchase orders that do not match the contract
  • invoices for extra work
  • unclear service confirmations
  • repeated urgent requests
  • suppliers asking for approval of additional hours
  • internal users requesting work outside the agreement
  • delivery follow-up becoming unclear
  • disputes about what was included

This is why operative buyers need access to the contract, SOW, SLA, and change-order process. Without that information, it becomes difficult to know whether an invoice or request is valid.


How scope creep connects to procurement management

Procurement management should ensure that the organization has a consistent way to prevent and manage scope creep.

This can include:

  • RFQ templates
  • SOW templates
  • SLA templates
  • approval rules
  • contract governance
  • change-order procedures
  • stakeholder training
  • supplier communication rules
  • escalation routines
  • spend control
  • lessons learned

Scope creep is not only a supplier issue. It is also a governance issue.

If the organization allows uncontrolled changes, suppliers will adapt to that behavior. Over time, informal changes become normal, and procurement loses commercial control.


Where scope creep fits in the procurement process

Scope creep can appear after contract award, but it is usually created much earlier. Buyers should manage scope risk throughout the procurement process.

1. Need definition

The first step is to define the business need clearly.

The buyer should ask stakeholders what problem they are trying to solve, what outcome they expect, what must be included, and what would be considered out of scope.

2. Service Description

The Service Description should explain what service is being purchased. It should include service users, locations, volumes, service hours, responsibilities, and key requirements.

This gives suppliers the practical picture of the service.

3. Statement of Work

The SOW should define the actual work. It should include deliverables, tasks, milestones, assumptions, exclusions, responsibilities, and acceptance criteria.

This is one of the most important documents for preventing scope creep.

4. SLA

If service performance matters, the SLA should define measurable service levels, reporting, escalation, and consequences for poor performance.

The SLA prevents disagreements about how well the service must be performed.

5. RFQ package

The RFQ package should include the Service Description, SOW, SLA, pricing format, evaluation criteria, supplier response instructions, and contract terms.

This helps suppliers quote on the same requirement.

6. Supplier questions

Supplier questions during the RFQ are valuable. They often reveal unclear scope, missing information, unrealistic requirements, or conflicting assumptions.

Procurement should use supplier questions to improve the final scope before contract award.

7. Supplier evaluation

When evaluating suppliers, procurement should review not only price but also assumptions, exclusions, deviations, and scope understanding.

A supplier with a low price but many exclusions may not be the best offer.

8. Negotiation

Negotiation should clarify the final scope. Any changes agreed during negotiation must be documented.

Verbal clarification is not enough.

9. Contract signing

The final SOW, SLA, Service Description, and change-control process should be part of the signed contract or clearly referenced in it.

10. Contract implementation

During implementation, both parties should review the scope, responsibilities, reporting, escalation, and change-control process.

This prevents misunderstandings when the supplier starts delivery.

11. Supplier performance management

During delivery, any request outside the agreed scope should follow the change-control process.

Performance reviews should include scope, changes, open claims, service issues, and improvement actions.


How to prevent scope creep before the RFQ

The best way to manage scope creep is to prevent it before suppliers submit quotations.

Define the business problem first

Before writing the scope, procurement should understand the problem the business wants to solve.

For example, instead of saying, “We need consulting support,” the buyer should ask:

  • What outcome do we need?
  • What problem must the supplier solve?
  • What deliverables are expected?
  • What decisions will this work support?
  • What internal resources are available?
  • What is not included?

Use a clear Service Description

The Service Description should make the service understandable before the SOW becomes too detailed.

It should answer:

  • What service are we buying?
  • Who will use the service?
  • Where will it be delivered?
  • How often will it be needed?
  • What volumes are expected?
  • What are the main responsibilities?
  • What is excluded?

Build a strong Statement of Work

The SOW should be specific enough for suppliers to quote correctly.

It should include:

  • background
  • objectives
  • scope
  • exclusions
  • deliverables
  • timeline
  • milestones
  • buyer responsibilities
  • supplier responsibilities
  • assumptions
  • constraints
  • acceptance criteria
  • change-control process

Include the SLA when performance matters

For recurring services, the SLA should define performance expectations such as response time, resolution time, uptime, reporting, quality, staffing levels, or customer satisfaction.

Without an SLA, the supplier may meet the scope but fail the expected performance level.

Ask suppliers to state assumptions and exclusions

The RFQ should require suppliers to clearly state assumptions, exclusions, dependencies, and deviations.

This helps the buyer identify hidden scope differences before supplier selection.

Use a structured pricing format

A pricing template can reduce scope creep by making cost drivers visible.

For example, the RFQ can ask suppliers to price:

  • fixed scope
  • optional scope
  • hourly rates
  • extra work
  • travel cost
  • additional users
  • additional locations
  • after-hours support
  • change requests

This makes it easier to understand what happens when the scope changes.


Change control: the practical tool for managing scope creep

Not all changes are bad. Business needs change. Projects develop. Services evolve.

The issue is whether changes are controlled.

A good change-control process defines how changes are requested, reviewed, approved, priced, and documented.

A simple change-control flow

  1. A change need is identified.
  2. The requester describes the change.
  3. The supplier assesses impact on cost, timeline, resources, risk, and service level.
  4. Procurement or the contract owner reviews the impact.
  5. The authorized approver approves or rejects the change.
  6. The change is documented in a change order or contract amendment.
  7. The supplier performs the changed work.
  8. The change is tracked in cost, delivery, and performance follow-up.

This process protects both buyer and supplier.

The buyer avoids uncontrolled cost.
The supplier avoids unpaid extra work.
The stakeholder gets a clear decision.


Example: scope creep in an IT support agreement

A company buys IT support for 300 users. The RFQ includes a Service Description, SOW, and SLA.

The original scope includes:

  • remote support for standard office software
  • on-site support for hardware issues
  • support during office hours
  • monthly reporting
  • agreed response times
  • one headquarters location

After contract start, the business asks the supplier to support:

  • 80 additional users
  • two new regional offices
  • weekend support
  • additional software applications
  • onboarding training for new employees

The supplier agrees informally because they want to support the customer. After two months, the supplier sends an invoice for additional work.

The stakeholder is surprised. Procurement checks the contract and sees that the extra users, locations, applications, and weekend support were not included.

This is scope creep.

The better approach would have been to handle the new requirements through a formal change request. The supplier should have described the cost, resource impact, SLA impact, and implementation timeline before starting the expanded service.


Example: scope creep in a consulting assignment

A buyer contracts a consulting company to deliver a market analysis report within six weeks.

The SOW includes:

  • supplier market overview
  • cost driver analysis
  • risk assessment
  • final report
  • one presentation to management

During the assignment, internal stakeholders request:

  • additional interviews
  • competitor benchmarking
  • country-specific legal review
  • two extra workshops
  • a revised management presentation
  • implementation support

The consultant performs the work, but later claims additional fees. The business argues that the activities were part of “normal consulting support.”

The dispute happens because the SOW did not clearly define:

  • number of interviews
  • number of workshops
  • number of report revisions
  • what was out of scope
  • how additional work would be approved

A stronger SOW would have made the boundaries clear.


Common warning signs of scope creep

Procurement should pay attention to early warning signs.

These include:

  • suppliers asking for more time without clear reason
  • suppliers referring to “additional work”
  • stakeholders requesting supplier support directly
  • invoices exceeding purchase orders
  • repeated change requests without documentation
  • unclear acceptance of deliverables
  • internal disagreement about what was included
  • supplier performance discussions shifting to scope disputes
  • more meetings, reports, or deliverables than originally agreed
  • service volumes increasing without contract review

The earlier procurement identifies these signs, the easier it is to regain control.


Common mistakes buyers make with scope creep

Mistake 1: Treating scope creep as only a supplier problem

Scope creep is often created by unclear internal requirements, weak governance, or informal stakeholder behavior. Procurement should manage both supplier behavior and internal discipline.

Mistake 2: Sending the RFQ without a clear SOW

If suppliers quote on an unclear SOW, the buyer cannot properly compare offers.

Mistake 3: Forgetting exclusions

Exclusions are as important as inclusions. They define the boundary of the supplier’s responsibility.

Mistake 4: Allowing verbal changes

Verbal changes are difficult to control. Any change affecting cost, time, service level, or responsibility should be documented.

Mistake 5: Not reviewing supplier assumptions

Supplier assumptions can limit responsibility. Buyers should review them carefully before contract award.

Mistake 6: Confusing flexibility with lack of control

A good supplier relationship should be flexible, but flexibility must still be managed through agreed rules.

Mistake 7: Ignoring small changes

Many small changes can create a large commercial impact. Small changes should still be visible and tracked.

Mistake 8: Not linking change control to payment

If payment for extra work is possible, the contract should define how extra work is approved before the supplier performs it.


Practical checklist: how buyers can control scope creep

Before RFQ:

  • Define the business problem.
  • Prepare a clear Service Description.
  • Create a structured SOW.
  • Include exclusions.
  • Add acceptance criteria.
  • Include an SLA when service performance matters.
  • Use a pricing template that shows optional and extra work.
  • Ask suppliers to state assumptions and deviations.

Before contract signing:

  • Review supplier assumptions.
  • Clarify exclusions.
  • Confirm final deliverables.
  • Confirm buyer and supplier responsibilities.
  • Make the final SOW part of the contract.
  • Make the SLA part of the contract if relevant.
  • Include a change-control clause.
  • Define who can approve changes.

After contract start:

  • Hold a contract implementation meeting.
  • Explain the change-control process.
  • Track change requests.
  • Compare invoices against contract and approved changes.
  • Review scope issues in supplier meetings.
  • Document all approved changes.
  • Escalate uncontrolled changes early.

Example wording: change-control clause

The following example is for educational purposes only and should be adapted to the specific contract, service, jurisdiction, and company requirements.

Change-Control Clause

Any change to the agreed scope, deliverables, timeline, service level, responsibilities, or pricing shall be handled through a formal change-control process.

The party requesting the change shall submit a written change request describing the requested change and the reason for the change.

The supplier shall assess the impact of the requested change, including effects on price, timeline, resources, risks, service levels, and contract obligations.

No change shall be binding unless approved in writing by the buyer’s authorized representative.

The supplier shall not begin work on any change that affects price, timeline, service levels, or responsibilities before written approval has been provided.

Approved changes shall be documented as a change order, contract amendment, or other agreed written record and shall form part of the contract documentation.


Link to related course: RFQ template

To prevent scope creep, the buyer must start before the supplier is selected.

The Learn How to Source course RFQ template is the most relevant course connection because scope control begins with a strong RFQ package. The RFQ should include a clear Service Description, Statement of Work, SLA where relevant, pricing structure, supplier response instructions, and contract terms.

Scope creep also connects closely to Service Description, Statement of Work, and Service Level Agreement and Change Management learning areas.


FAQ: Scope creep in procurement

What is scope creep in procurement?

Scope creep in procurement means that the work, service, deliverables, responsibilities, or expectations expand beyond what was originally agreed with the supplier.

Why does scope creep happen?

Scope creep often happens because the requirement is unclear, the SOW is incomplete, exclusions are missing, supplier assumptions are not reviewed, or changes are handled informally.

Is scope creep always bad?

Not always. Business needs can change, and some changes are necessary. The problem is uncontrolled scope creep, where changes are not approved, priced, documented, or managed.

How can buyers prevent scope creep?

Buyers can prevent scope creep by defining the Service Description, SOW, SLA, exclusions, acceptance criteria, pricing model, and change-control process before contract award.

What is the connection between SOW and scope creep?

The SOW is one of the most important tools for preventing scope creep. It defines what work is included, what is excluded, who is responsible, what deliverables are expected, and how completion is accepted.

What is the connection between SLA and scope creep?

The SLA defines the expected performance level. Without a clear SLA, the supplier and buyer may disagree about response time, availability, reporting, service quality, or escalation.

Who should approve scope changes?

Only authorized representatives should approve scope changes. The contract should define who has authority to approve changes that affect cost, timeline, service levels, or responsibilities.

How does scope creep affect supplier invoices?

Scope creep can lead to invoices for extra work. If the extra work was not formally approved, the buyer and supplier may disagree about whether the invoice is valid.


Conclusion: scope creep is prevented before the contract is signed

Scope creep is not only a project-management problem. It is a procurement problem.

It happens when the buyer, supplier, and internal stakeholders do not share the same understanding of what is included, what is excluded, how performance is measured, and how changes are approved.

The best way to control scope creep is to start early. Define the service clearly. Build a strong Statement of Work. Include an SLA where performance matters. Ask suppliers to state assumptions and exclusions. Make the final scope part of the contract. Use formal change control after award.

The practical next step is to review one current service or project contract. Check whether the SOW clearly defines scope, exclusions, deliverables, responsibilities, acceptance criteria, and change control.

If those elements are missing, scope creep is not a possibility. It is a likely future problem.
